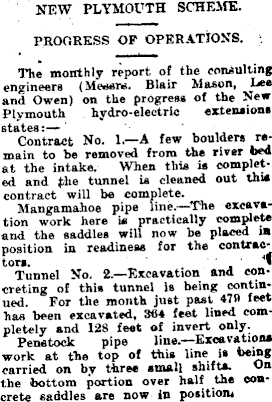

HYDRO-ELECTRIC WORKS.
NEW PLYMOUTH SCHEME. PROGRESS OF OPERATIONS. The monthly report of the consulting engineers (Messrs. Blair Mason, ls?e and Owen) on the progress of the New Plymouth hydro-electric extensions Sta Contract No. I.—A few boulders remain to be removed from the river bed at the intake. When this is completed and the tunnel ia cleaned out this contract will be complete. Mangamahoe pipe line.—The excavation work here is practically complete and the saddles will now be placed in position in readiness for the contractors. , 1 Tunnel No. 2.—Excavation and concreting of this tunnel is being continued. For the month just past 479 feet has been excavated, 364 feet lined completely and 128 feet of invert only. Penstock pip e line. —Excavations work at the top of this line is 'being carried on by three small shifts. On the bottom portion over half the concrete saddles are now in position,
Permanent link to this item
Hononga pūmau ki tēnei tūemi
https://paperspast.natlib.govt.nz/newspapers/TDN19220218.2.31
Bibliographic details
Ngā taipitopito pukapuka
Taranaki Daily News, 18 February 1922, Page 4
Word count
Tapeke kupu
150HYDRO-ELECTRIC WORKS. Taranaki Daily News, 18 February 1922, Page 4
Using this item
Te whakamahi i tēnei tūemi
Stuff Ltd is the copyright owner for the Taranaki Daily News. You can reproduce in-copyright material from this newspaper for non-commercial use under a Creative Commons Attribution-NonCommercial-ShareAlike 4.0 International licence (CC BY-NC-SA 4.0). This newspaper is not available for commercial use without the consent of Stuff Ltd. For advice on reproduction of out-of-copyright material from this newspaper, please refer to the Copyright guide.
